From Statoil to the StateSaved by the B deck?

Modules for Gullfaks A

person BY OLE KVADSHEIM, NORWEGIAN PETROLEUM MUSEUM
After the deck frame for Gullfaks A was launched on February 22, 1985, the next phase was module lifting. The various modules for Gullfaks A were built in multiple locations, mostly in Norway, before being transported to Stord for installation.
Module M12 arrives at Stord Yard on a barge. Photo: Kyllingstad/Furunes/Equinor
— Module M12 arrives at Stord Yard on a barge. Photo: Kyllingstad/Furunes/EquinorKyllingstad/Furunes/Equinor
© Norsk Oljemuseum

Aker Stord had the contract to build the deck frame, but most of the individual components were constructed elsewhere and transported to Stord for installation after the deck had been launched.

Dividing the deck construction into smaller modules was not unique to Gullfaks A; the same approach had been used for the Statfjord platform decks. Statoil actively promoted this method.

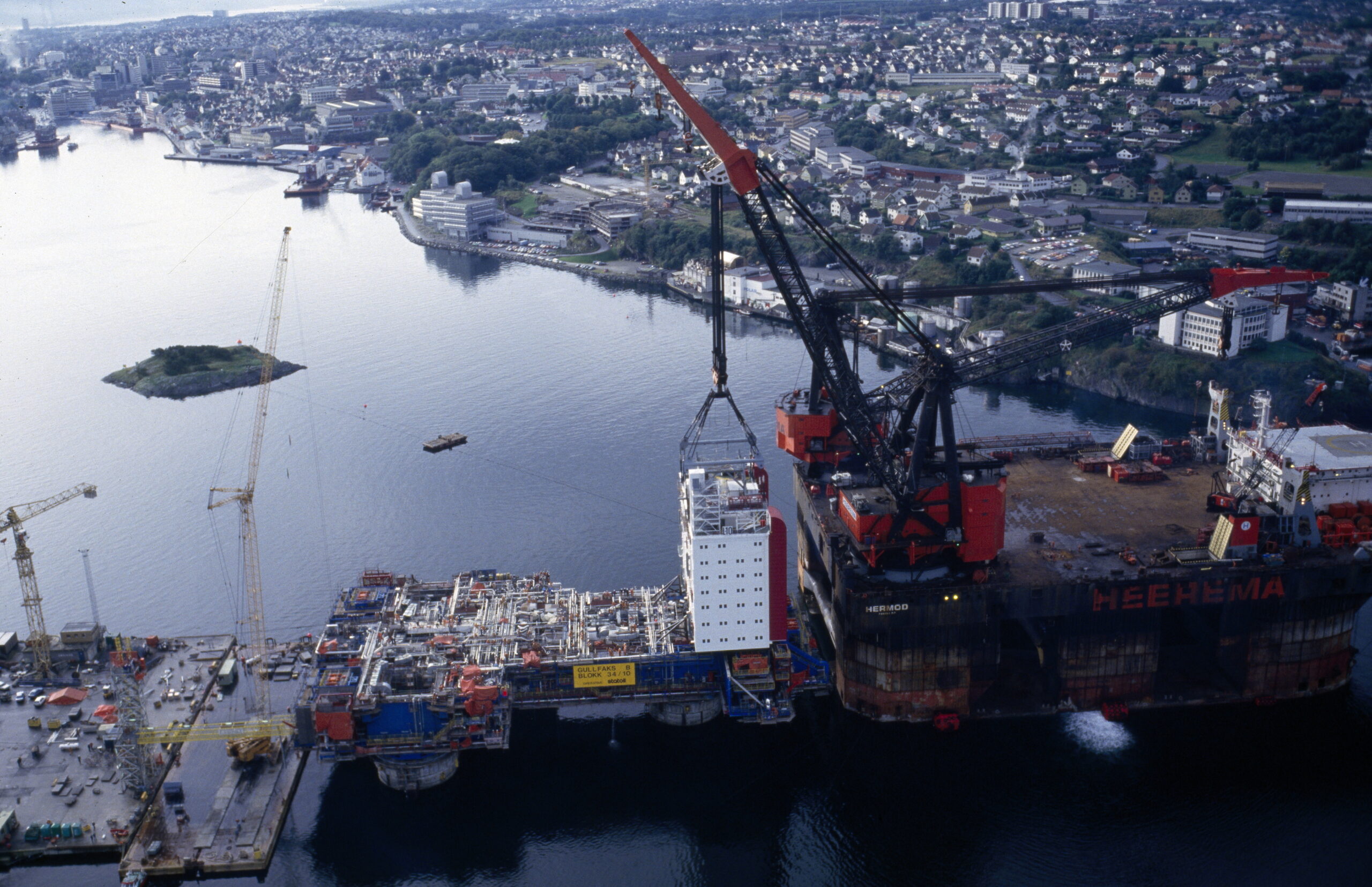

The living quarters module is lifted into place. Photo: Øyvind Hagen/Equinor
The living quarters module is lifted into place. Photo: Øyvind Hagen/Equinor

Arve Johnsen saw modularization as a way to strengthen the Norwegian supplier industry. Statoil had pushed for this approach during the Statfjord project and, unsurprisingly, used the same strategy when acting as the operator for Gullfaks A. Breaking the project into smaller contracts made it possible for Norwegian yards and workshops to take on more of the work.[REMOVE]Fotnote: Thomassen, E. (2022). Statoil og Equinor – 1: Middel og mål: 1972–2001 (s. 143).

Many of the contracts for Gullfaks A deck modules were signed during the summer of 1983. Just before the summer holiday that year, contracts worth NOK 250 million were awarded.[REMOVE]Fotnote: Status: internavis for Statoil-ansatte. (1983). Nr. 12 s. 2.

Module contracts for the Gullfaks A deck

What  Number  Who  Where
Living quarters  L11, L12, L13  Leirvik Sveis  Stord
Emergency generator module  M21  Nordoffshore  Sandnessjøen
Flare boom  M26, M27  Nordoffshore  Sandnessjøen
Power station module  M22  Kværner Brug  Egersund
Control and switchgear rooms  M11, M12  Aker Verdal  Verdal
Water injection and process support  M13, M23  Sterkoder  Kristiansund
Compressor module  M24  Aker Verdal  Verdal
Gas processing module  M14  Horten Verft  Horten
Separation modules  M15, M25  De Groot  Netherlands
Wellhead modules  M16, M17  Belleli  Italy
Drilling tower, substructure, and pipe storage    Moss Rosenberg Verft  Stavanger
Drilling module  D11  Bergen Mekaniske  Bergen
Helideck, elevator, and hangar    Oil Industry Services  Kristiansand
Gas turbines and separator    Kværner Brug  Oslo

📷 Caption: The table shows who built the different Gullfaks A deck modules and where they were constructed.

(Source: Status: internal newspaper for Statoil employees, 1983, No. 16, p. 10.)

Two international companies were awarded major contracts: the Dutch company De Groot was responsible for building the separation modules (M25 and M15), while the Italian company Belleli built the two wellhead modules (M16 and M17).

The image shows the relative placement of the modules. The western side of the platform (housing area - L13) is on the far left, while the drilling module is on the far right. Source: Status (internal newspaper for Statoil employees, 1983, No. 16, p. 10)

Module lifting and final assembly

Once the deck frame was launched and placed on temporary concrete legs on February 22, 1985, module lifting could begin. Lifting and integration of the modules continued throughout the year.

This marked the beginning of a new phase, requiring a significant increase in manpower. The influx of workers exceeded the available housing capacity, so, in agreement with local authorities, many workers were housed in temporary barracks and even in buildings still under construction.[REMOVE]Fotnote: Status: internavis for Statoil-ansatte. (1984). Nr. 18.s. 15.

The work generally proceeded smoothly, but in the final stages of construction, on November 7, 1985, a miscalculation caused a critical issue. The weight load on the seawater shaft, located beneath the living quarters on the platform’s western side, was too high. The “shock absorbers” between the deck and the concrete structure (crush tubes) had buckled under the pressure, shifting an excessive portion of the deck’s weight onto one of the concrete legs.

After a few days, the deck was lifted, and steel plates were inserted between the deck and the concrete legs to redistribute the weight evenly. There was never any danger to personnel, but all work was halted until the issue was resolved.

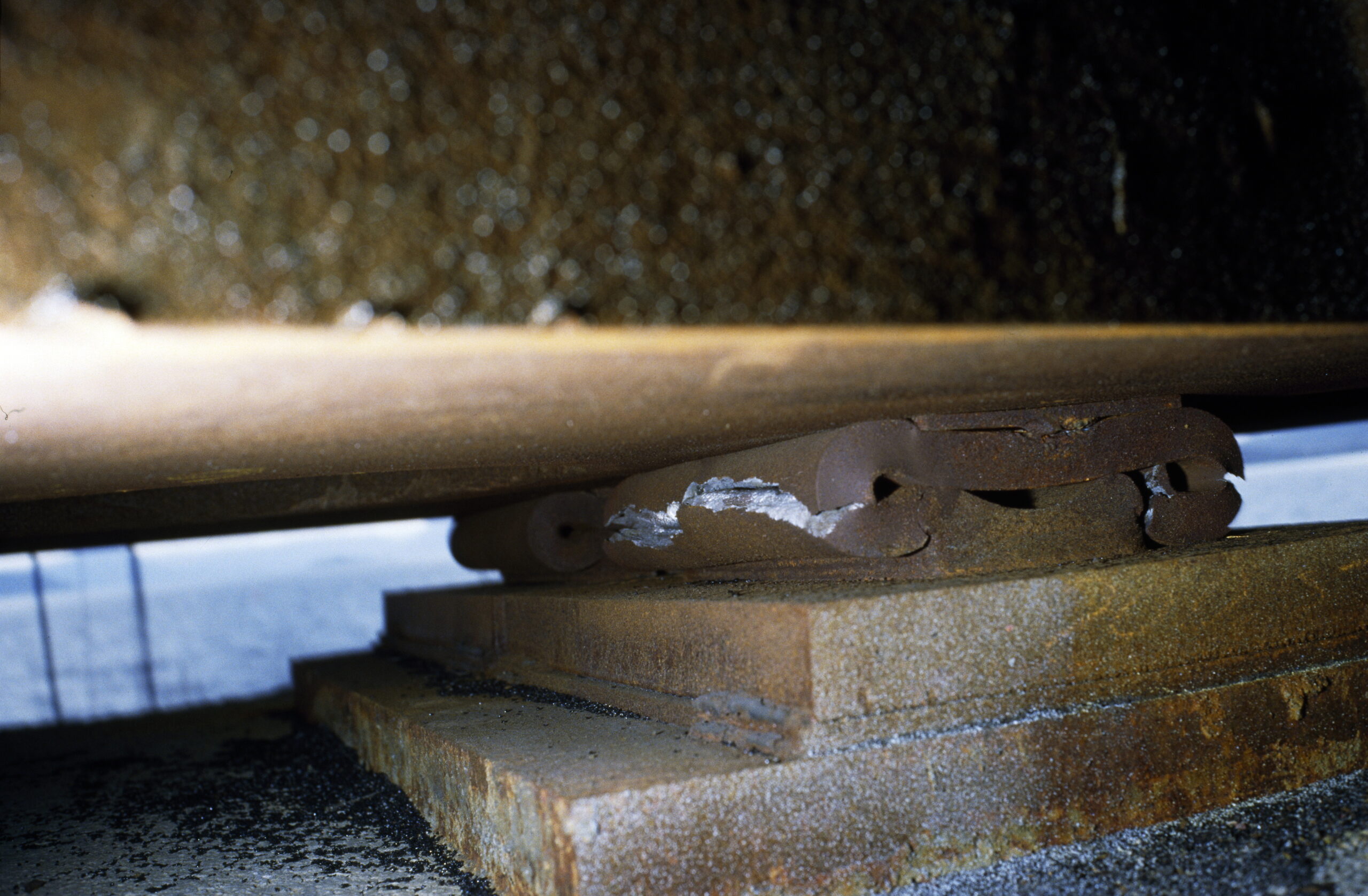

The crush tubes on the platform’s western side were… crushed. Photo: Leif Berge/Equinor



By the turn of the year 1985/1986, the deck was ready for departure from Stord. The journey continued to Digernessundet, where it was mated with the concrete substructure. Statoil had initially planned for Aker Stord to handle the deck-to-substructure connection as an extension of their deck construction contract. However, this work was awarded to Norwegian Contractors, the company that had built the concrete substructure.[REMOVE]Fotnote: Stavanger Aftenblad (1983, 3. februar). Vellykket Gullfaks-kobling. s. 22.
